How To Calculate Spi In Project Management

SPI is calculated by dividing earned value (EV) by planned value (PV): SPI = EV / PV.

Understanding project health is crucial, and one vital metric is the Schedule Performance Index, or SPI. It shows if your project is on, ahead of, or behind schedule. Knowing how to calculate SPI in project management helps you proactively manage timelines.

This simple calculation provides a clear indication of your project’s efficiency. It allows you to make data driven decisions. Use the index to monitor progress and make adjustments as needed.

How to calculate spi in project management

How to Calculate SPI in Project Management

Okay, let’s talk about something super important in project management: the Schedule Performance Index, or SPI. Think of SPI as a report card for your project’s schedule. It tells you whether you’re keeping up with your planned timeline, falling behind, or even moving ahead! Knowing how to calculate SPI is a handy skill that helps you keep your project on track. It’s like having a GPS for your project timeline, guiding you to a successful finish.

Understanding the Basics: What is SPI?

Before we dive into the calculation, let’s make sure we understand what SPI actually is. SPI is a ratio, a number, that compares how much work you’ve actually completed to how much work you planned to complete by a certain point in time. It’s a key part of Earned Value Management (EVM), a project management technique. A good SPI means your project is right where it’s supposed to be schedule-wise. An SPI lower than 1 means you’re behind schedule, and an SPI higher than 1 means you’re ahead! That sounds pretty useful, doesn’t it?

The Earned Value (EV) Concept

To understand SPI, we need to know about Earned Value (EV). Imagine you’re building a Lego castle. Earned Value is like measuring how many bricks you’ve actually put in place compared to the planned number of bricks at this stage. EV is the value of work actually completed. It’s not about how much money you’ve spent or how much time you’ve taken. It’s solely about the value of the work that’s finished.

  • Planned Value (PV): This is the authorized budget assigned to the scheduled work. It’s how much work you planned to have completed by now. Let’s say your Lego castle plan shows that 100 bricks should be done by day 5, then 100 bricks is your PV.
  • Earned Value (EV): This is the value of work you’ve actually completed. If on day 5, you completed only 80 bricks instead of 100, then 80 bricks value is your EV.

Remember, EV and PV both are measured in monetary value so you can use them even in different types of projects, for example: if you are building an actual house then the value of work can be measured in actual dollars value of work completed.

The Formula: How to Calculate SPI

Now for the main event! Here’s the simple formula you need to calculate SPI:

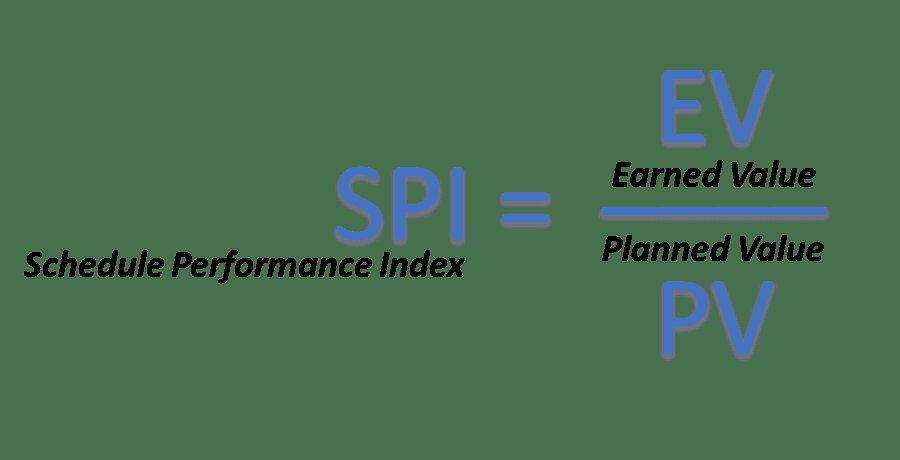

SPI = Earned Value (EV) / Planned Value (PV)

It’s a simple division problem, really. You take the Earned Value (value of the completed work) and divide it by the Planned Value (value of the work you were supposed to complete). Let’s see some detailed explanation using different scenarios.

Scenario 1: The Ideal Case

Let’s imagine a project with clear tasks and a clear schedule. Suppose, according to the schedule, you should have completed tasks worth $5,000 by the end of the week. Now, suppose you actually did complete exactly those tasks. Here’s how you calculate SPI:

  • Earned Value (EV): $5,000 (the value of tasks completed)
  • Planned Value (PV): $5,000 (the planned value of tasks)
  • SPI = EV / PV = $5,000 / $5,000 = 1

An SPI of 1 tells us that you’re perfectly on schedule. The project is moving according to the plan.

Scenario 2: Behind Schedule

Let’s say you are not on schedule now. According to your plan, you were supposed to complete tasks worth $6,000, but you only completed tasks worth $4,500. Here’s how to calculate SPI:

  • Earned Value (EV): $4,500
  • Planned Value (PV): $6,000
  • SPI = EV / PV = $4,500 / $6,000 = 0.75

An SPI of 0.75 is less than 1, so it tells us that you’re behind schedule. For each dollar of work you were supposed to complete, you only completed 75 cents worth of work. This might mean you need to speed things up to get back on track. This also means it will now take much longer to complete the project.

Scenario 3: Ahead of Schedule

Sometimes, you can complete tasks quicker than planned. Let’s say your planned value of completed tasks was $4,000, but due to your hard work, you managed to complete tasks worth $5,000. Let’s calculate the SPI:

  • Earned Value (EV): $5,000
  • Planned Value (PV): $4,000
  • SPI = EV / PV = $5,000 / $4,000 = 1.25

An SPI of 1.25 is more than 1, so it tells us that you’re ahead of schedule. This is great news but also a good opportunity to see if some planned resources can be reallocated to other projects if this project is finished early.

Interpreting the SPI Value

The SPI value is not just a number; it tells a story about your project’s progress. Here’s a handy guide to help you understand what your SPI is telling you:

  • SPI = 1: Your project is perfectly on schedule. You’re completing the work exactly as planned.
  • SPI < 1: Your project is behind schedule. You need to identify the reasons for the delay and make necessary changes to get back on track.
  • SPI > 1: Your project is ahead of schedule. You’re completing work faster than planned. This is great news but requires careful management of resources.

Why Calculating SPI Matters

Calculating SPI is important for a number of reasons. First and foremost, it provides valuable insights into your project’s schedule performance. It’s like having a health checkup for your project, showing you where things are going well and where you might need some help. Let’s see a deeper explanation.

Early Problem Detection

SPI helps you spot potential delays early on. If your SPI is consistently below 1, you know there’s a problem with your scheduling. Early detection of issues makes it easier to correct them and avoid major delays later on. In this case, you can apply some techniques like a crash program to make sure project does not get delayed.

Accurate Project Forecasting

By knowing your SPI, you can create more realistic estimates for project completion dates. If your SPI is consistently low, you can revise your schedule to reflect this and communicate a more accurate deadline to stakeholders. This helps to keep everyone informed and expectations in check.

Better Decision-Making

SPI allows for better resource management. If your SPI is high, you might reallocate resources to other projects or even finish the project early. On the other hand, if your SPI is low, you can make necessary changes by allocating more resources to complete the project within the deadline. This gives project managers the necessary data to take informed actions.

Improved Communication

SPI provides a clear way to communicate schedule performance to all project stakeholders. Whether it’s your client, team members, or managers, everyone can easily understand the project’s status using SPI. It’s a simple and universal way to report project progress. Using an SPI will help project managers communicate with senior management or the client easily.

Tools to Help Calculate SPI

You don’t have to calculate SPI with a calculator and paper every time. There are many tools available that can make the process easier. Here are a few examples:

  • Spreadsheets: Tools like Microsoft Excel or Google Sheets can be set up to calculate SPI automatically using formulas and values.
  • Project Management Software: Many project management tools like Asana, Microsoft Project, or Monday.com have built-in features to calculate SPI and other Earned Value metrics.
  • EVM Software: Specialized software designed for Earned Value Management (EVM) can provide detailed reports and analysis of project performance, including SPI.

Tips for Effective SPI Tracking

To get the most value out of SPI tracking, here are a few tips:

  • Consistent Tracking: Track your SPI regularly, not just at the end of the project. Frequent tracking helps you identify issues as they occur.
  • Accurate Data: Make sure your Planned Value and Earned Value data is correct. Errors in the data can throw off the SPI calculation.
  • Review and Analyze: Don’t just calculate the SPI and forget about it. Review it and analyze the cause if it’s below or above the desired value. Take appropriate actions based on your findings.
  • Communicate Findings: Share the SPI with the project team and stakeholders. This allows everyone to be aware of the project’s schedule performance.

Advanced SPI Applications

As you become more comfortable with SPI, you can explore more advanced uses. These might include:

  • Combining SPI with Cost Performance Index (CPI): This provides a more comprehensive view of project performance, showing both cost and schedule status.
  • Trend Analysis: Track SPI over time to see if performance is improving or getting worse. This helps you make predictions about future project performance.
  • Forecasting Completion Dates: Use the current SPI value to forecast realistic project completion dates. This will make you more accurate at giving final dates to stakeholders.

Common Mistakes to Avoid When Calculating SPI

While the SPI calculation itself is simple, there are some common mistakes people make. Avoiding these errors is important for accurate project tracking:

  • Inconsistent Unit: Use consistent units to measure both EV and PV. For example, don’t mix dollar values with percentages. This will give a wrong SPI. Always use the same unit value for both EV and PV.
  • Ignoring Resource Allocation: SPI does not consider resource allocation, focusing solely on schedule and work performance. If your project is delayed due to resource unavailability, SPI might be misleading.
  • Delay in Updates: If the project data is not updated regularly, the SPI results can be outdated and misleading. Make sure to have data up-to-date to have accurate information.
  • Not Considering Dependencies: SPI doesn’t consider task dependencies. If task A depends on task B, and task B is delayed, this can negatively affect the overall project.

A Practical Example: Building a Website

Let’s take a practical example. Suppose you are building a website, and your plan breaks down into different phases. Let’s say, by week 2, you were supposed to finish designing the homepage and coding the contact form for $2000 of planned value, but you only managed to complete the homepage design worth $1000.

  • Planned Value (PV) by week 2: $2000
  • Earned Value (EV) by week 2: $1000
  • SPI = EV / PV = $1000 / $2000 = 0.5

Your SPI is 0.5, which means the project is running much behind schedule. Now, you can analyze this and take appropriate steps to make sure it gets back on track.

Calculating SPI is a very useful skill for anyone managing a project. It’s a simple but powerful way to keep your project on track. Understanding the formula, applying it correctly, and interpreting the results will help you stay ahead and deliver successful projects on time. It helps you understand what you are doing wrong and correct your mistakes. By using the SPI metric and combining it with other project management techniques, you can greatly enhance your project management capabilities and ensure projects are completed effectively and efficiently.

Cost Performance Index and Schedule Performance Index – CPI and SPI Example

Final Thoughts

To calculate the Schedule Performance Index (SPI), you divide earned value (EV) by planned value (PV). SPI indicates schedule efficiency; a value of one means the project is on schedule. An SPI less than one signals delays, while an SPI over one suggests the project is ahead.

Understanding how to calculate spi in project management is vital for accurate tracking. Use it to assess progress and make necessary adjustments. This makes managing schedules and keeping project timelines a lot easier.
